Gold Mine, Ghana

DCA conducted a comperehensive 18-month drilling optimization project for Rocksure International's open-pit gold mine in Ghana.

The program included training courses for 130 participants.
Key results include, among others, reducing rock tools costs -54% and a possibility to reduce fleet size -25%

The 18-month drilling optimization project was initiated after a short two-day site evaluation as time was limited. DCA submitted a report where we highlighted the issues as we saw them, with initial ideas on how to solve them.

The report was reviewed and topics discussed with the client, after which DCA submitted a full proposal with KPIs and pricing.

Initial target KPIs for the program were agreed as follows:

KPI
TARGET
Rock tools $/m reduction
-15'%
Improve lineal meter per EH
+15%
Availability target (specifically older model machines)
>85%
Utilization target
>85%
Better correlation - linear meters to blast volume
AGREED
Reduce fuel oils and lubes per EH
AGREED
Better recording of operational delays and analysis
AGREED
Weekly task update, meeting
AGREED
Monthly reporting
AGREED

‍

What did we do?

DCA delivered a full 18-month drilling optimization program including:

  • Training and support programs for.
    - drill operators
    - offsiders
    - supervisors & leading hands
    - mechanics
    With an unofficial drill bits and rock tools management program
  • Resourcers for training purposes:
    - Evaluation matrix per program to establish base line and pattern recognition
    - Workbook detailing and recording full program: record of theory training and assessment, practical training delivery, consolidation phase and assessment
    - Sandvik DPi simulator training
  • Reduce rock tools CPM
  • Increase utilization rates of drills
  • Increase availability rate of drills
  • Achieve better correlation between linear drilled meters and blasted volume
  • Re-drilling rates
  • Productivity rates per engine hour of drills
  • Improve shift reporting and data captured
  • Improve cross department communication
  • Staff ownership and responsibilities – staff job descriptions for accountability

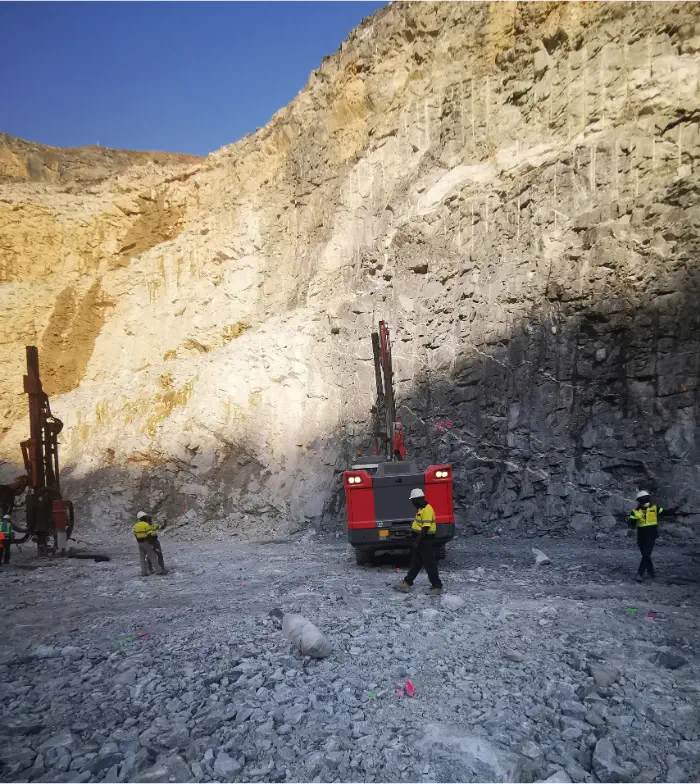

Sandvik DPi drill rigs and DCA team at Rocksure International's open pit mine in Ghana

During the program, DCA held altogether 160 courses to 130 participants.

Image: An example of a pre-program drilling evaluation matrix
An example of a pre-program drilling evaluation matrix

Could you also benefit from an outsider's view? Or perhaps there's a need for staff training?

Let's talk and see how we could help you!

CONTACT US

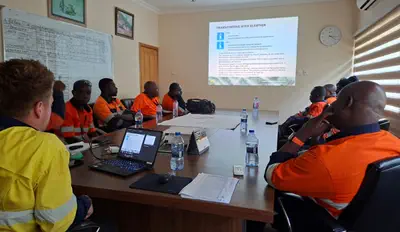

DCA classroom training for drill operators

‍

Drilling optimization results & feedback

The program was very successful. One of the KPI's, +15% improvement on drilled meters per engine hour, was clearly surpassed. The key here, though, is efficiency as the initial target KPI of reducing rock tools cost per meter was -15% but the reduction was more than double, -54%.
‍
Despite aging equipment, the availability percentage has improved to over 85% from a sub 70% level. Total fleet productivity and efficiency increased to the level where total fleet size is possible to reduce by about 25%

‍

KPI
TARGET
ACHIEVED
Rock tools $/m reduction
-15%
-54%
Improve lineal meter per EH
+15%
+47%*
‍
Availability target (specifically older model machines)
>85%
ACHIEVED
‍
Utilization target
>85%
NOT ACHIEVED**
Better correlation – linear meters to blast volume
AGREED
YES
Reduce fuel oils and lubes per EH
AGREED
YES
Better recording of operational delays and analysis
AGREED
YES
Weekly task update, meeting
AGREED
YES
Monthly reporting
AGREED
YES
*It must be noted that ground some conditions are favorable in certain areas and all gains are not purely because of DCA program.

**Determined as a mining sequence issue to be resolved, DCA has increased utilization and productivity to the point where two machines can be removed from the equipment forecasts for monthly planning.

Mechanics commented on how many aspects of the machine and its functionality really opened up to them. Adopting the learnings to everyday repair and maintenance work is showing results. Drillers found that they understand the control system functionality and configuration better, which opens new techniques for drilling more efficiently.

In all cases, staff thought they already knew everything but learned quickly that there is so much they did not know.

The outcomes were achieved due to multiple factors:

  • increased fleet productivity and efficiency to the level where totalfleet size is possible to reduce by about 25 %
  • Improved hole accuracy and minimized deviation due to better understanding of collaring and drilling pressures
  • Understanding the control system functionalities and how to set parameters to allow the system to operate as engineered
  • Minimizing “stuck in hole” situations due to better understanding and control of automated systems
  • Significant reduction in redrill percentage because of improved collaring techniques and drilling support functions by personnel
  • Over drilling minimized by implementing backup procedures to depth counter failures
  • Rock tools maintenance procedures enforced to achieve maximum bit life, sustained pen rates and minimized stress on rock drill component
DCA classroom training for drill operators

Other DCA Offering for Best Mining Efficiency

Equipment transport Sleipner
Sleipner DB series lowboy trailer

Could your mine site benefit from a drilling optimization program?

Contact us today and let's see together how your operations could be optimized for the best possible ROI.

CONTACT US
Esa Yrjänä, Managing Director, DCA Systems Ltd.
DCA Systems Ltd..
10 Osae Link
East Legon
Accra, Ghana
info@dcafrica.co

Stay updated

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.
LinkedIn
Privacy policy DCA © 2026 All rights reserved.
